Most small residential asbestos removals involve 1–5 days of active work on site, but the full process from inspection to official clearance commonly runs 2–4 weeks for a typical Australian home. That gap catches a lot of homeowners off guard. The contractor who quotes “one day” is usually talking about the hours they spend physically removing material, not the inspection, lab results, regulatory notifications, clearance air monitoring, and disposal paperwork that bookend the job.

Three things move the needle most:

Safe Work Australia’s Model WHS Regulations set the national framework that state regulators like SafeWork NSW build their licensing and notification rules on. Missiondemolition operates under those rules on every job.

Pro Tip: Book your follow-on trades (tilers, painters, plasterers) at least two weeks after your planned removal date, not the day after. Lab results and clearance certificates take time, and a failed clearance adds another 2–5 days before anyone else can re-enter the work zone.


Key takeaways

Most residential asbestos removal projects in Australia run 2–4 weeks from inspection to clearance certificate, even when active removal takes only 1–5 days.

Point Details
Full timeline vs active removal Active removal takes 1–5 days; the full inspection-to-clearance process typically runs 2–4 weeks.
Notification buffer NSW requires up to 5 business days’ notice before licensed removal starts; factor this into your schedule before booking trades.
Lab turnaround impact PLM/PCM results take 24–72 hours; TEM can take 1–5 business days; each failed clearance adds 2–5 days.
Clearance before reoccupation No one should re-enter a work zone until an independent clearance certificate is issued in writing.
Missiondemolition Handles licensed removal, ARCP, independent monitoring, and disposal under one contract, with confirmed timelines from the first inspection.

Table of Contents

What does the asbestos removal timeline look like, stage by stage?

Each stage has its own time window, and they stack sequentially. You cannot skip ahead.

Inspection and sampling

An accredited asbestos assessor visits the site, collects bulk samples from suspect materials, and sends them to a NATA-accredited laboratory. On-site time is typically 1–3 hours for a standard home. Lab turnaround depends on the method: PLM (polarised light microscopy) and PCM (phase contrast microscopy) results usually come back within 24–72 hours; TEM (transmission electron microscopy), used for low-level clearance work and some friable jobs, can take 1–5 business days unless you pay for a rush service.

Asbestos removal control plan and regulatory notifications

Once lab results confirm asbestos is present, the licensed contractor prepares an Asbestos Removal Control Plan (ARCP). This document covers containment methods, PPE requirements, decontamination procedures, and disposal routes. Preparing and reviewing an ARCP adds days to the pre-removal schedule, particularly on complex jobs. Under the Model WHS Regulations, licensed removalists must notify the relevant state regulator before starting certain classes of work. In NSW, SafeWork NSW requires five business days’ notice for licensed asbestos removal work. That notification window alone can add a week to your schedule if you have not planned for it.

Containment and site setup

Contractors seal off the work area with polyethylene sheeting, establish decontamination units (showers, change areas), and set up negative-pressure HEPA filtration where required. For a single room, setup takes half a day to a full day. A multi-room or whole-house job can take 1–2 days just to establish containment properly.

Active removal

Non-friable materials (bonded fibro sheeting, floor tiles, roof sheeting) are wet-cut or carefully removed intact to minimise fibre release. A single-room job typically takes 4–8 hours of active removal. Multi-room or whole-house non-friable work runs 2–4 days. Friable removal (pipe lagging, sprayed insulation, loose-fill) is slower, more controlled, and almost always requires more stages. Friable removals can require multiple days and repeated clearance testing, with a Class A licensed contractor on site throughout.

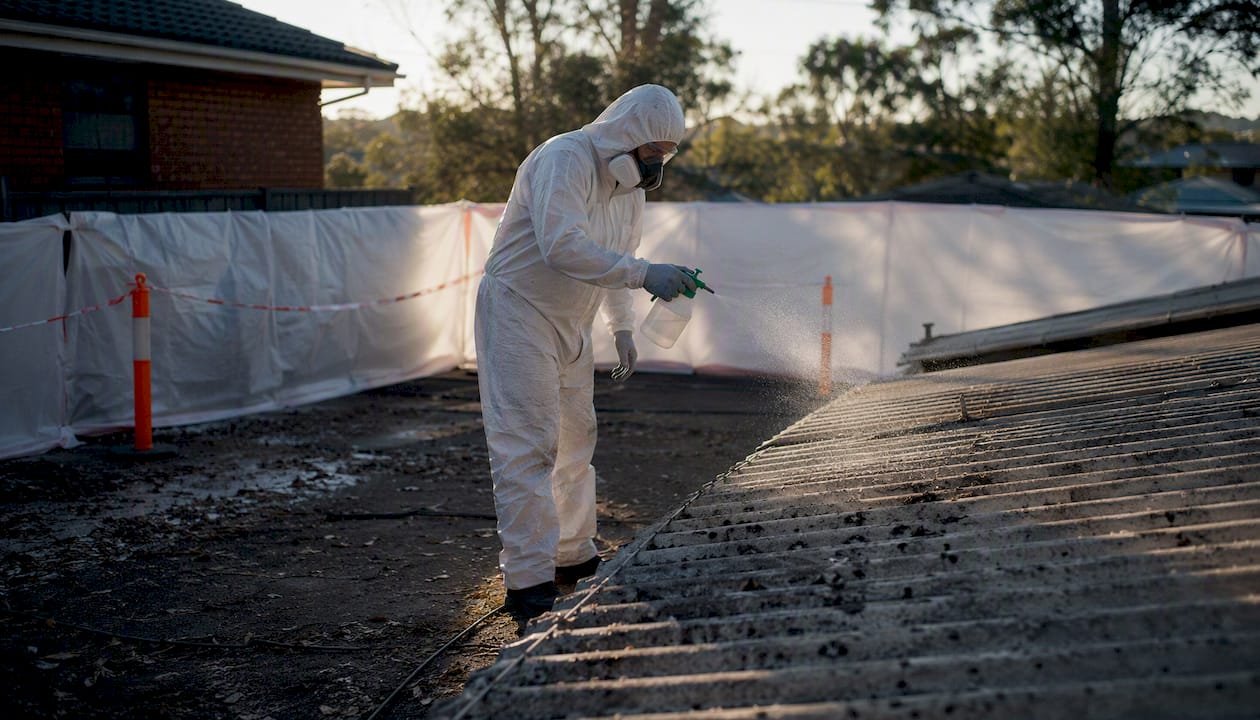

Wet spray asbestos removal procedure close-up

Final cleanup, visual inspection, and clearance air monitoring

After removal, the contractor does a detailed visual inspection of the contained area, then an independent hygienist or occupational hygienist conducts clearance air monitoring. Samples are sent to a NATA-accredited lab. If results pass, a clearance certificate is issued. If they fail, the contractor re-cleans, and the whole monitoring cycle repeats. Each failed clearance cycle typically adds 2–5 days.

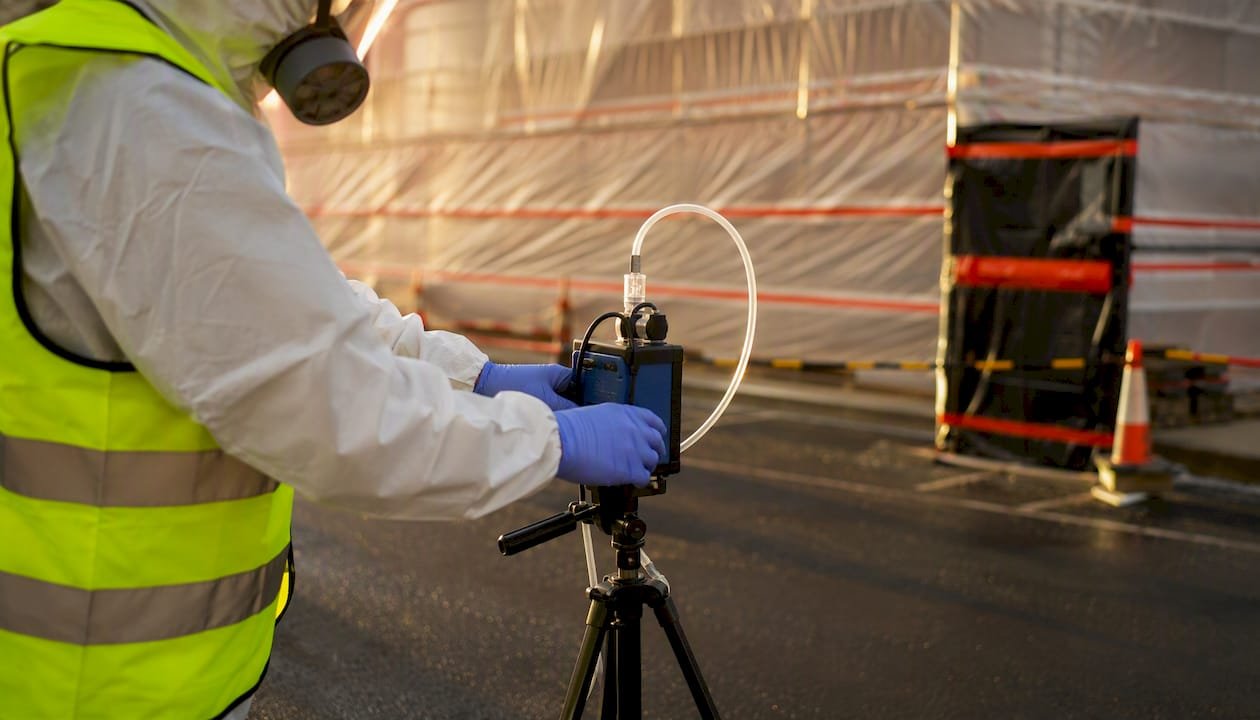

Air monitoring pump near asbestos containment site

Disposal and manifest paperwork

Asbestos waste must be transported to a licensed disposal facility in sealed, labelled packaging. A waste transport certificate (manifest) tracks the chain of custody from site to tip. Completing and filing this paperwork usually takes a few hours, but transport logistics can add half a day depending on the facility’s location and operating hours.

Stage Typical duration
Inspection and sampling 1–3 hours on site; 24–72 hrs (PLM/PCM) or 1–5 days (TEM) for lab results
ARCP preparation and regulatory notification 1–3 days (ARCP); up to 5 business days (notification window)
Containment and site setup Half day to 2 days depending on scope
Active removal 4–8 hours (single room) to 4+ days (whole house or friable)
Clearance air monitoring and lab results 1–3 days per cycle; add 2–5 days per failed clearance
Disposal and manifest paperwork Half day to 1 day

Pro Tip: Ask your contractor to submit the regulatory notification on the day lab results come back positive, not when they are ready to start work. That five-business-day clock starts ticking from the notification date, so every day you wait is a day added to your schedule.


Day-by-day example timelines for small, medium, and complex jobs

Small job: single room floor tiles or a ceiling patch

You likely do not need to vacate the whole house for a contained single-room job, but you should keep children and pets out of the area and adjacent rooms during active removal and monitoring.

Medium job: multiple rooms, popcorn ceilings, attic insulation

Whole-home temporary relocation is worth considering here, especially if the attic or ceiling space is involved. Fibre migration through ceiling penetrations is a real risk during active work.

Complex job: whole-house friable removal or multi-trade site

Whole-house asbestos abatement typically runs 2–4 weeks end-to-end. Add friable materials and you are looking at the upper end of that range or beyond. A multi-trade construction site with concurrent works can push the schedule further because clearance certificates must be issued before other trades re-enter the asbestos work zones.

Expect:

Pro Tip: On complex jobs, ask for a zone-by-zone clearance schedule in writing before work starts. This lets your builder and other trades plan re-entry dates for each area rather than waiting for the entire site to clear at once.


What factors make the asbestos removal timeline longer or shorter?

The condition and type of asbestos, its location, and the need for third-party clearance monitoring are the primary drivers of how long a removal takes. Beyond those, several practical factors can add days you did not budget for.

Pro Tip: Always ask your contractor whether the quoted scope includes a contingency for hidden material. A fixed-price quote with no contingency clause means any surprise discovery becomes a variation, and variations add both cost and time.


How does testing, lab analysis, and clearance work in Australia?

Asbestos abatement in Australia follows a four-phase process: pre-work survey and notification, containment, wet-method removal with HEPA filtration, and post-abatement clearance testing. The testing and clearance phases are where most schedule uncertainty lives.

Sampling strategy

Accredited assessors use a homogeneous area sampling approach. For a given material type in a given area, the standard practice involves collecting multiple samples (commonly three to seven per homogeneous area, depending on the area’s size and variability) to confirm identification and inform the removal scope. More samples mean more lab submissions and potentially longer wait times before the ARCP can be finalised.

Lab methods and turnaround

PLM identifies asbestos type and is the standard method for bulk material identification. PCM counts airborne fibres and is used for clearance air monitoring. Both typically return results within 24–72 hours from a NATA-accredited lab. TEM provides higher sensitivity and is used for low-level clearance testing after friable removal or in situations where PCM results are borderline. TEM turnaround runs 1–5 business days under standard conditions; rush TEM can return results in 24 hours but at a significant cost premium.

Lab turnaround is the single most common cause of a project running longer than the quoted removal days. A standard PLM result takes 24–72 hours; a TEM result under standard conditions takes up to 5 business days. If your clearance sample requires TEM and the lab is at capacity, that alone can push your reoccupation date back by nearly a week.

Clearance air monitoring and pass criteria

An independent hygienist (not the removal contractor) conducts clearance air monitoring after the visual inspection passes. In Australia, the clearance criterion for non-friable removal is typically below 0.01 fibres per millilitre of air, assessed by PCM. Friable removal clearance uses more stringent criteria and often requires TEM. If the sample fails, the contractor re-cleans the contained area and the hygienist returns for another round. Each failed cycle adds 2–5 days. You can read more about what the asbestos clearance inspection process involves and what a pass or fail looks like.

Regulatory requirements

Under the Model WHS Regulations, licensed removal is mandatory for friable asbestos of any quantity and for non-friable asbestos above 10 square metres. Independent clearance by a licensed asbestos assessor is required before the area can be reoccupied. State regulators enforce these requirements; SafeWork NSW publishes the specific licence classes and verification steps for NSW projects.


How to schedule your renovation around asbestos removal

Getting the sequencing right saves you from paying idle tradespeople and from reoccupying a space before it is safe.

Before you book anything:

Booking buffers to build in:

Household logistics:

Coordinating with builders and other trades:

Contractor vetting checklist:

Pro Tip: Request the clearance certificate as a PDF the same day it is issued. Do not rely on the contractor to forward it later. You need that document before any other trade re-enters the zone, and delays in receiving it can hold up your entire renovation schedule.


How does the timeline affect what you pay?

Time and cost are directly linked in asbestos removal, and understanding where the billing structure sits helps you read a quote critically.


Are there alternatives to removal, and how do they affect timing?

Removal is not always the only option under Australian practice. Encapsulation and management-in-place are accepted in specific circumstances.

Encapsulation involves applying a sealant to bonded, non-friable asbestos materials that are in good condition and not likely to be disturbed. It is faster than removal, typically completed in a day or two, and does not require the same containment infrastructure. There is no active removal, so the clearance requirements are less intensive. The trade-off is that the material remains in place and must be managed, inspected regularly, and disclosed to future owners or tenants.

Management in place means leaving identified asbestos materials undisturbed, documenting their location in an asbestos register, and monitoring their condition over time. This is appropriate for materials in good condition that will not be disturbed by planned works. It adds no time to a renovation schedule because no physical work is done, but it creates an ongoing management obligation.

Neither option is appropriate for:

Pro Tip: If you are planning a renovation that will disturb the area where asbestos is present, encapsulation is not a long-term solution. You will need removal before the renovation proceeds, so the time saving from encapsulation now becomes a double-handling cost later.


Missiondemolition: Australian timelines, compliance, and real project examples

Missiondemolition holds the licences required for both Class A (friable) and Class B (non-friable) asbestos removal across residential, commercial, and industrial sites throughout Australia. Every project includes an ARCP prepared before work starts, independent air monitoring arranged through NATA-accredited hygienists, and waste manifests completed and filed at the point of disposal.

A typical Missiondemolition residential job runs like this: A homeowner in Sydney’s inner west contacts us after discovering fibro sheeting under their bathroom tiles. We arrange an accredited inspection within 48 hours, submit samples to a NATA-accredited lab, and have confirmed results back within 72 hours. The ARCP is prepared and the SafeWork NSW notification submitted the same day results arrive. Active removal takes one day. Independent clearance air monitoring is conducted the following morning, with PCM results returned within 24 hours. The clearance certificate is issued and emailed to the homeowner by Day 10 from first contact. Their tiler starts Day 12.

Compliance checklist for Australian asbestos removal projects:

For a detailed walkthrough of the asbestos clearance certificate process, including what the certificate must contain and how long it takes to issue, Missiondemolition’s guide covers each step.

Pro Tip: Keep a copy of every document: the lab report, the ARCP, the notification confirmation, the clearance certificate, and the waste manifest. If you sell the property or a future renovation disturbs adjacent areas, this paper trail protects you legally and speeds up any future assessment.


What actually causes schedule surprises on asbestos jobs

The jobs that run over schedule almost always share the same handful of problems. Hidden material is the biggest one. A homeowner books a single-room tile removal, and the assessor finds fibro backing board under the tiles, asbestos rope around the bath waste pipe, and a patch of textured ceiling coating that was not visible in the original inspection. Each discovery triggers a scope change, a revised ARCP, and potentially a new notification window. What looked like a 10-day project becomes three weeks.

Poor site preparation is the second most common cause. Contractors arrive to find the work area not cleared, access blocked, or adjacent rooms full of furniture that needs to be moved before containment can be established. Every hour of delay on Day 1 of setup pushes the clearance date back.

Lab delays are the third. Standard turnaround is 24–72 hours for PLM/PCM, but labs run at capacity during busy periods. A sample submitted on a Thursday afternoon may not return results until Tuesday. If that sample is a clearance result and it fails, the re-test cycle does not start until Wednesday at the earliest.

Missiondemolition manages these risks by submitting samples early in the day, maintaining relationships with multiple NATA-accredited labs to route around capacity constraints, and building contingency days into every project schedule from the outset. When a re-test is needed, the hygienist is already booked for the following morning rather than scheduled from scratch.


Missiondemolition makes the booking process straightforward

Asbestos removal in Sydney and across Australia does not have to mean weeks of uncertainty. Missiondemolition’s process is built around giving you a confirmed timeline from the first call.

Missiondemolition

Here is how it works: you contact Missiondemolition for a site inspection, an accredited assessor visits within 48 hours, samples go to a NATA-accredited lab, and you receive a scoped quote with a staged timeline once results are confirmed. Licensed removal, independent air monitoring, disposal, and clearance documentation are all handled under one contract. No chasing separate hygienists or labs.

What Missiondemolition handles on your behalf:

Ready to get a confirmed timeline for your project? Request a quote for asbestos removal in Sydney or visit the professional asbestos removal services page to see the full scope of what is covered.
